Construction Cash Flow Forecasting Picture this: a general contractor closes out its best year yet. Revenue is up 30%. The P&L shows a healthy profit. And yet the owner is staring at a payroll due Friday with barely enough in the operating account to cover it.

This scenario plays out constantly in construction. Materials get purchased and crews get paid weeks before the client's check arrives. Being profitable on paper means nothing if the cash isn't in the bank when bills come due.

For founder-led contractors doing $1M-$15M in revenue, cash flow forecasting isn't bookkeeping busywork. It's the difference between funding growth confidently and scrambling for a line of credit at the worst possible moment.

This guide covers why forecasting matters, how to build one step by step, the mistakes that trip up most contractors, and when it's time to bring in outside financial expertise.

Key Takeaways

  • Cash flow forecasting predicts inflows and outflows so you can spot shortfalls before they hit
  • Construction's preconstruction, active-build, and closeout phases each carry distinct cash timing risks
  • Underbilling, weak WIP tracking, and reactive planning are the most common forecasting failures
  • A rolling forecast (updated weekly or monthly) beats any static, one-time projection

Why Construction Cash Flow Forecasting Matters

Construction runs on a payment mismatch. You front the cost of labor, materials, and mobilization, then wait — sometimes months — to get paid. Most other industries don't operate this way.

The numbers back this up. CFMA's 2025 Construction Financial Benchmarker found the industry's average accounts receivable cycle sat at 55.2 days for fiscal year 2024, based on data from over 1,500 companies. That's nearly two months between finishing work and getting paid for it.

Payment delays have gotten worse. A 2024 industry report found 82% of contractors experienced payment delays exceeding 30 days, up sharply from 49% just two years prior. That same report estimated slow payments cost the U.S. construction sector $280 billion in 2024 alone.

What this means for you:

  • Forecasting surfaces cash shortfalls weeks in advance, not the day before payroll
  • Early warning gives you time to negotiate financing on your terms, not under duress
  • Prevents last-resort borrowing at high interest rates when options have run out
  • Separates job profitability (what the P&L shows) from cash timing (what your bank account shows)

A job can be profitable and your business can still run out of cash. Forecasting is how you catch that gap before it catches you.

How to Build a Construction Cash Flow Forecast

Building a usable forecast comes down to four steps. Skip any one of them, and the whole model loses accuracy fast.

Step 1: Map Out Cash Inflows

Start with every dollar you expect to receive, and tie each one to the actual contract date, not a rough guess.

  • Progress and milestone payments tied to specific completion percentages
  • Retainage releases, typically 5%-10% of billed amounts held back until specific contract or closeout conditions are met
  • Deposits collected at contract signing or mobilization
  • Equipment or material resale income from surplus inventory

Use the actual date in the contract or payment schedule. "Client usually pays in 45 days" is a guess. "Payment due November 15 per contract terms" is a forecast.

Step 2: Forecast Cash Outflows

Next, list every category of cash going out the door:

  • Labor and payroll (including burden and overtime)
  • Materials and supplier invoices
  • Subcontractor payments
  • Equipment rental or purchase
  • Permits and fees
  • Overhead — office, insurance, admin
  • Loan and equipment financing payments

Flag large one-time purchases, like a piece of heavy equipment, separately from recurring monthly costs. Mixing them together hides the real pattern of your regular burn rate.

Step 3: Calculate Net Cash Flow and Apply Cost Curves

The formula itself is simple:

Net Cash Flow = Total Inflows − Total Outflows

Run this weekly or monthly, project by project and rolled up company-wide.

Then apply a cost curve to distribute remaining budget realistically across the schedule instead of assuming even spending:

Curve type Spending pattern
S-curve Slow start, ramps up mid-project, tapers at close
Front-loaded Heavy costs early (mobilization, materials)
Back-loaded Costs escalate toward project end
Linear Steady, even spending throughout
Bell Slow start, peak in the middle, slow finish

Construction cost curve types comparison chart for cash flow forecasting

Most projects follow an S-curve or front-loaded pattern given how construction spends on materials and mobilization early. Applying the wrong curve to your remaining budget will throw off every forecast that follows.

Step 4: Report, Compare, and Adjust

A forecast built once and filed away is worthless three weeks later. Keep it alive with a simple cadence:

  • Update on a rolling basis: weekly if you're juggling multiple active jobs, monthly at minimum
  • Compare projected numbers against actual results every cycle
  • Use variances to spot where estimates were wrong and where problems are quietly building

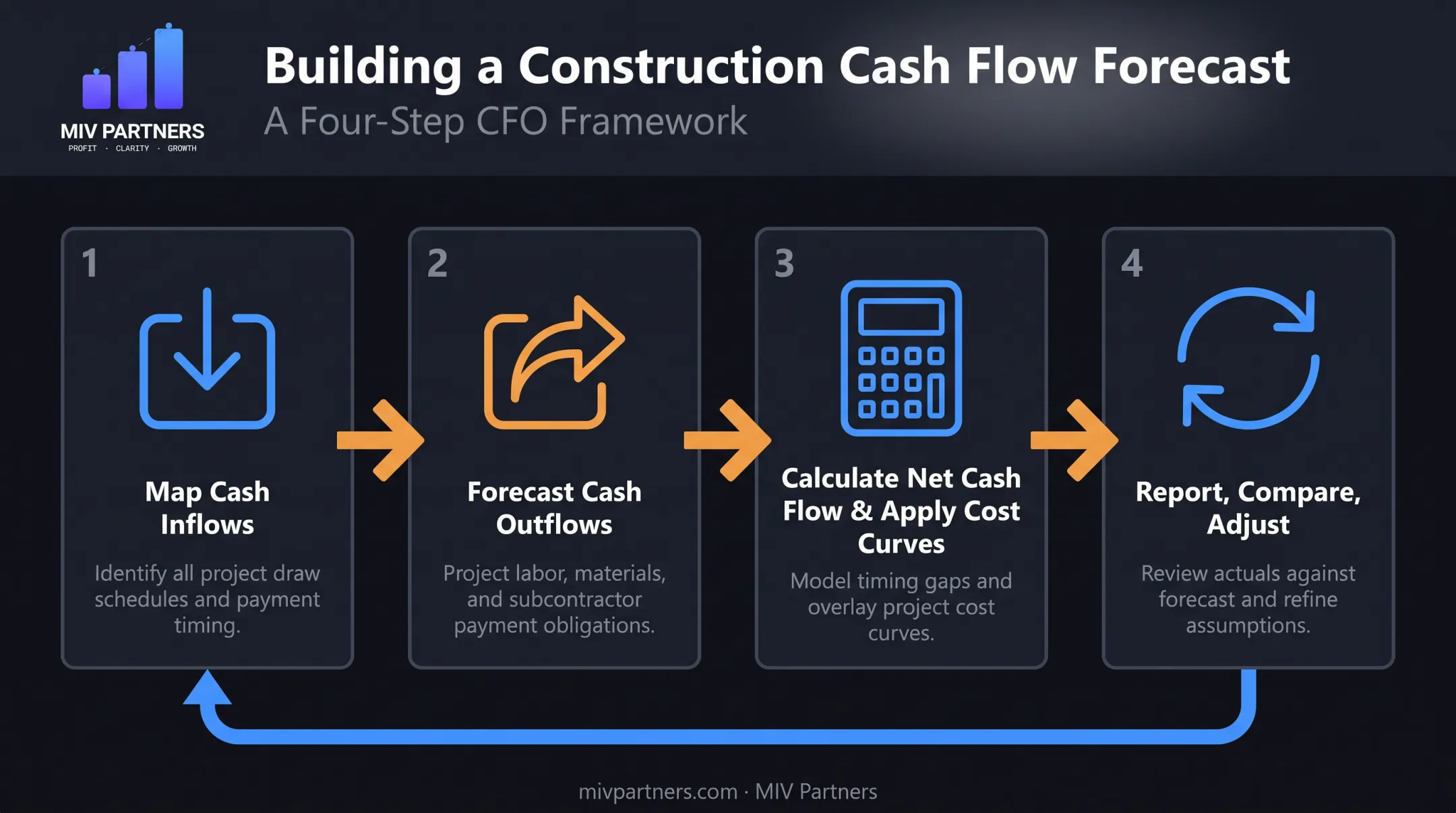

Four-step construction cash flow forecasting process from inflows to adjustments

Common Cash Flow Forecasting Mistakes That Hurt Contractors

Even contractors who forecast regularly fall into predictable traps.

Underbilling and overbilling distort your true position. CFMA defines underbilling as costs incurred but not yet billed, often a sign of missed change orders or bad cost-to-complete estimates.

Overbilling is the reverse: billing ahead of the work completed. Both mask your real cash position until the gap is too big to ignore. CFMA notes that overbillings tend to convert into profit, while underbillings tend to signal margin fade and, eventually, job losses. Timely billing drives timely collections. Slow billing drives slow collections and, eventually, bad debt.

Billing mistakes are only part of the picture. Other frequent traps include:

  • Relying on a one-time forecast instead of a rolling, continuously updated model
  • Ignoring retainage holdbacks and unresolved change orders when projecting inflows
  • Trusting gut instinct or a spreadsheet disconnected from actual job costing and schedules
  • Reviewing cash position only when things feel tight, instead of on a set cadence

Accounting for Work-in-Progress (WIP) in Your Forecast

A WIP schedule tracks three things for every active job: costs incurred, billings to date, and percentage of completion. It's the bridge between your accounting records and a forecast that reflects reality.

If a project has a $1 million budget and you've incurred $250,000 in costs, you're 25% complete and should have recognized 25% of revenue and gross profit accordingly. If billings are ahead of that percentage, you're overbilled. If they're behind, you're underbilled. AICPA guidance on WIP schedules walks through this percentage-of-completion approach in more detail.

Why this matters for cash flow:

  • WIP reveals overbilled or underbilled jobs before they distort your bank balance
  • It catches change orders and cost overruns before they compound
  • It flags problems early when reviewed with your cash forecast at least monthly

Running multiple projects without WIP visibility means you're forecasting cash blind. One underbilled job might be manageable. Three underbilled jobs running simultaneously is how contractors end up with a profitable P&L and an empty checking account.

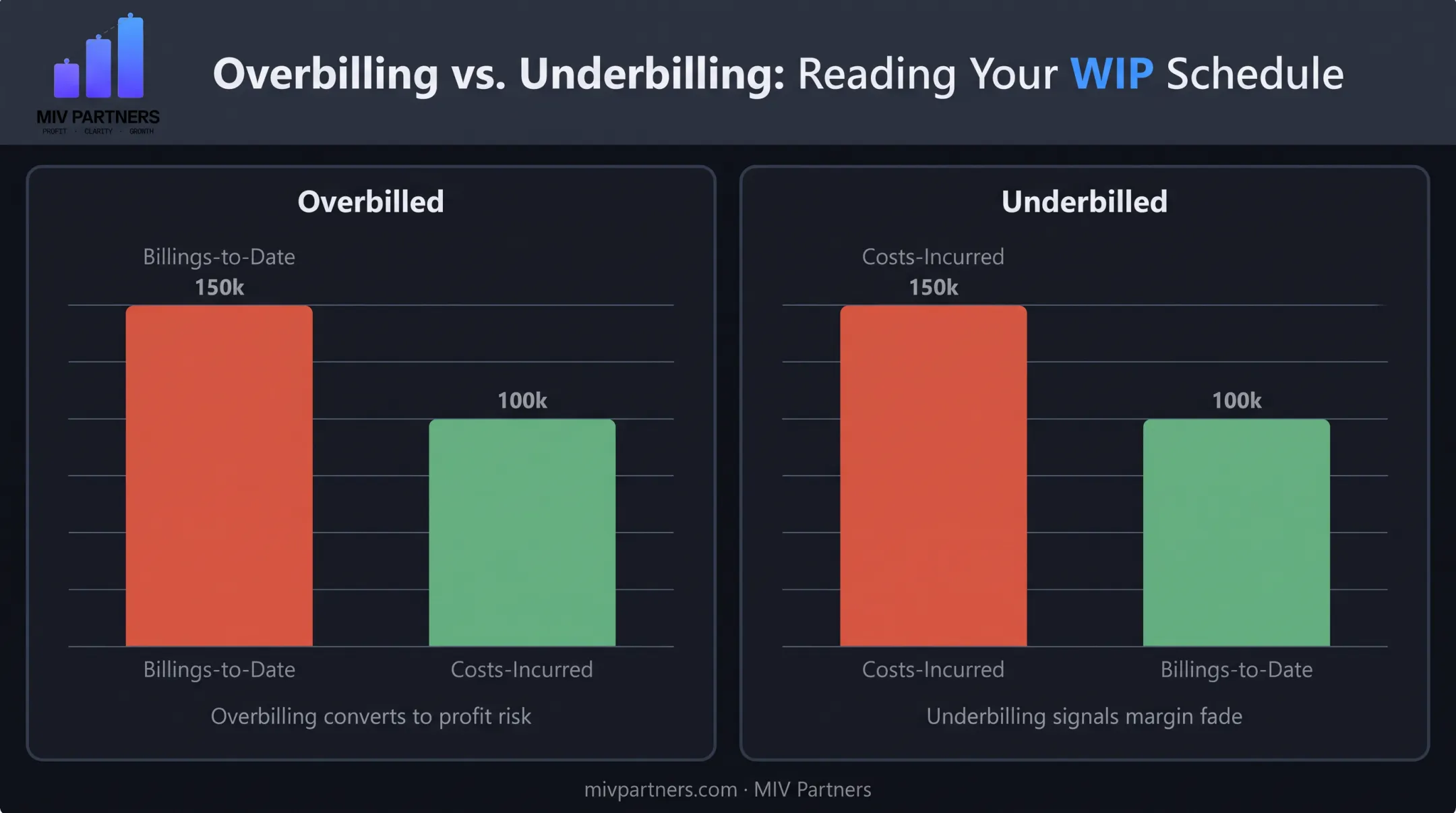

WIP schedule overbilling versus underbilling comparison for construction projects

When to Bring in Financial Expertise for Cash Flow Forecasting

Founder-led contractors often reach a point where basic bookkeeping isn't enough, but a full-time CFO still doesn't make sense. That gap is where cash flow problems take hold: revenue keeps growing, yet nobody has the bandwidth to build and maintain a real forecasting system.

Common signs it's time for outside financial expertise include:

  • Revenue is up, but cash in the bank stays unpredictable
  • Receivables stretch while payables and payroll stay fixed
  • Pricing, hiring, or expansion decisions lack a clear cash picture
  • Bookkeeping reports the past, but nothing guides the next 90 days

A fractional CFO advisory model fills that gap without a full-time hire. MIV Partners works with founder-led businesses generating $1M–$15M in revenue through a structured three-phase approach:

  1. Diagnose — Identify where cash flow gaps originate, establish a profitability baseline, and assess receivables, payables, and working capital
  2. Strategize — Build a forward-looking cash flow stabilization plan, pricing model, and capital plan tailored to your business
  3. Install — Implement rolling forecasts and executive dashboards that track cash position, margins, and other decision-relevant KPIs on an ongoing basis

Michel Chelnokov, founder of MIV Partners, brings a dual perspective as both a CPA and a practicing business owner. He focuses on the operational issues behind the numbers and what to do next, not only on reporting what already happened.

If you're not sure whether your cash flow issues stem from timing, billing practices, or something deeper, a complimentary CFO Financial Diagnostic session is a low-commitment way to find out before investing in ongoing advisory support.

Frequently Asked Questions

What are the three types of cash flow?

Operating cash flow covers day-to-day activity like job billings and payroll. Investing cash flow covers equipment purchases or sales. Financing cash flow covers loans, credit lines, and repayments.

How do you account for construction work-in-progress (WIP)?

Track costs incurred against billings to date for each active job. If billings exceed the percentage of work completed, you're overbilled; if costs incurred exceed billings, you're underbilled.

What is the first step in preparing a construction cash flow statement?

Identify and schedule every expected cash inflow using exact contract dates — progress payments, retainage releases, and deposits — rather than estimated averages.

What role does construction cash flow play in construction projects?

It determines whether you can pay crews, suppliers, and overhead on time. Without it, even a profitable project can stall due to a timing gap.

How often should a construction company update its cash flow forecast?

Weekly if you're running several active projects, monthly at a minimum. A rolling forecast that's constantly updated catches problems a static one-time projection will always miss.
